The most common question we hear after someone requests an estimate in Raleigh, Clayton, Cary, or anywhere across the Triangle is how long they need to plan around the work. The honest answer is 4 to 5 days in the rooms being refinished, plus several more days before heavy furniture goes back. What happens during those days, and what factors shift the timeline, is worth understanding before you schedule.
The Standard Timeline: Day by Day
This is what a typical hardwood floor refinishing job looks like from start to finish on a residential home in the 800 to 1,500 square foot range. The process is the same whether we are working in Raleigh, Clayton, or Cary.
Day 1
Initial Sanding

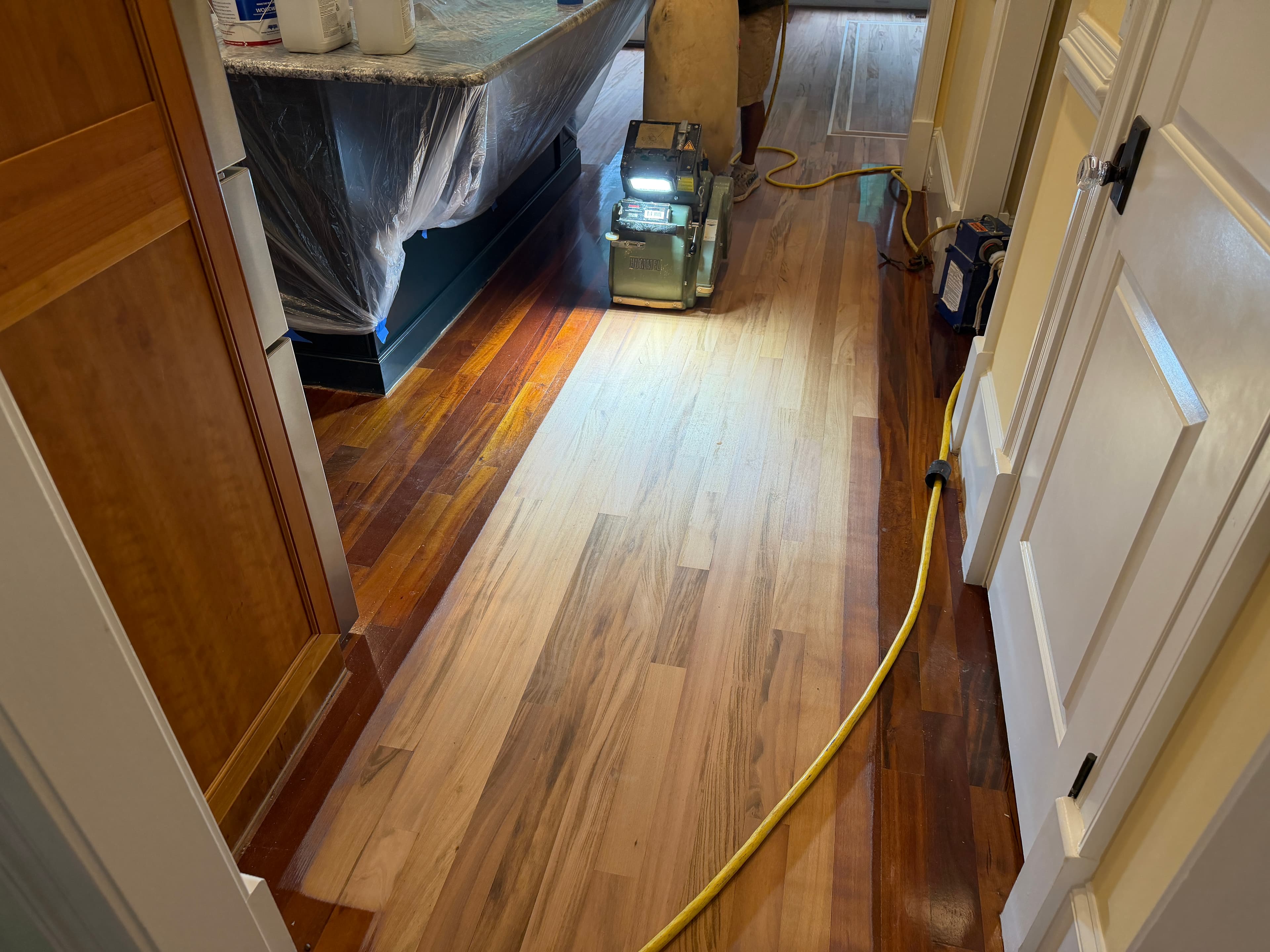

The first day is the most disruptive. A drum sander or belt sander makes multiple passes across the main field of the floor, cutting through the existing finish and removing surface scratches, staining, and discoloration down to bare wood. An edger works the perimeter, and detail work in corners and tight spots gets done by hand. By the end of day one, the floor is bare wood and the dust containment system has collected most of what came off. This is also when we assess whether any boards need repair or replacement before finishing proceeds. On older homes in areas like Raleigh or Clayton where floors may be 30 to 50 years old, finding boards that need lacing in is common and adds time to the overall schedule.
Day 2
Final Sanding Passes and Prep
The second day finishes what day one started. Progressively finer grits smooth the surface, remove any machine marks left by the drum sander, and bring the wood to the right profile for stain or finish adhesion. The floor is vacuumed, tacked, and inspected carefully under raking light before anything goes down. On floors receiving a clear finish with no stain change, the first finish coat may go down on the afternoon of day two.
Day 3 (stained floors only)
Water Popping and Stain Application
For floors receiving a stain color change, day three is the stain day. We apply water-popped stain preparation first, which opens the wood grain to accept stain more evenly and deeply. Stain is applied, worked into the grain, and wiped. The floor then dries overnight before the first finish coat can go down. Skipping overnight drying between stain and finish is one of the most common mistakes that causes adhesion failures, so this step does not get rushed. This is especially important on red oak floors, which are common in older homes throughout Wake Forest, Garner, and Knightdale.
Day 3 or 4
First and Second Finish Coats
The first finish coat seals the wood and stain. It dries for several hours, then the surface is lightly abraded with a screen or fine abrasive pad to remove any dust nibs and improve adhesion for the next coat. The second coat goes down the same day or the following morning depending on dry times and job size. Most residential refinishing jobs receive three coats of finish total.
Day 4 or 5
Final Finish Coat
The final coat is applied, the floor is left to dry undisturbed, and the job is done from our side. We go over the cure timeline with you before we leave: when you can walk on it in socks, when shoes are fine, when rugs can go back, and when it is safe to move furniture back in.
What Makes the Timeline Longer
The 4 to 5 day estimate applies to a straightforward job. Several factors can add time.
Staining vs. clear finish
Choosing a stain color adds approximately one day to the schedule. Stain needs to dry fully overnight before finish goes on top. Floors getting a clear or natural finish skip that step.
Square footage and room count
A single open-plan living area moves faster than a floor plan with many rooms, hallways, and closets. Each room boundary, doorway, and tight space adds hand work that the drum sander cannot reach. Larger jobs may run a full day longer.
Floor condition
Floors with significant cupping, deep staining, or boards that need repair before sanding can add a half to a full day depending on scope. We assess condition during the estimate and call out anything that will affect timing before work begins. For a full breakdown of what drives cost and timeline together, see our guide on what affects hardwood floor refinishing cost.
Number of finish coats
Most jobs get three coats. Some flooring situations or finish systems call for a seal coat plus three topcoats. Each coat adds dry time and an abrasion pass between coats, so additional coats extend the schedule modestly.
Dry Time vs. Cure Time: Why the Distinction Matters
The floor will feel dry to the touch long before it has reached full hardness. Dry time and cure time are not the same thing, and confusing them is how finishes get permanently damaged.
Dry time is when the surface has hardened enough for foot traffic without marking. That happens within 24 hours for most water-based finishes. Cure time is when the finish has completed its chemical cross-linking and reached its final hardness rating. That takes longer.
| Finish System | Light Traffic | Full Cure |
|---|---|---|
| Bona Traffic HD | 24 hours | 3 days |
| Bona Mega One | 24 hours | 5 days |
| Rubio Monocoat | 24 hours | 5 days |
Heavy furniture placed on a finish that is dry but not cured will leave permanent dents. Area rugs trap moisture and can cloud the finish if laid down too early. Both situations are avoidable by respecting the cure window. We use Bona Traffic HD on most jobs because its 3-day full cure is the fastest among the finishes we carry, and its durability over the long term is the best available for residential hardwood. For a deeper look at how each finish system performs, see our Bona Traffic HD vs. Rubio Monocoat comparison.
What to Do Before We Arrive
The more prep done before day one, the faster the job moves. A few things to handle before the crew arrives:
Clear the rooms completely
All furniture, area rugs, and decor need to be out of the rooms being refinished. We can help move large pieces for an additional charge, but the job moves faster when rooms are already empty.
Remove fragile items from shelves and walls
Sanding creates vibration throughout the floor structure. Items that can fall or shift should be taken down in the work area and adjacent rooms.
Plan for the floor to be out of use
Map out a path through the house that avoids the refinished area. If the entire main level is being done, plan to use a different entrance and keep the kitchen accessible or arrange for meals elsewhere during finish coat days.
Secure pets
Paws and claws on a fresh finish coat leave marks. Keep pets in a separate area of the house or off-site during the work and for 48 hours after the final coat.
Is Recoating Faster?
Yes, significantly. Hardwood floor recoating takes 1 to 2 days because there is no sanding to bare wood. The existing finish is lightly screened to degloss it, a fresh topcoat is applied, and the job is done. The tradeoff is that recoating cannot address deep scratches, staining, or discoloration, and it cannot change the stain color. It is the right service for a floor whose finish is wearing thin but whose wood is still in good condition.
We offer recoating throughout the Triangle, including Raleigh, Clayton, Cary, Wake Forest, Apex, and Garner.
If you are not sure which service your floor actually needs, the signs your floors need refinishing guide walks through the water test and visual indicators that point toward recoating vs. a full refinish.
Hardwood Floor Refinishing in the Triangle
12th And Oak Floor Co. has been refinishing hardwood floors across the Raleigh metro since 2002. The timeline and process described above applies to every job we do, regardless of location. If you want city-specific information including pricing context and what to expect for your area, visit the page for your city:
Questions and Answers
How long does it take to refinish hardwood floors?
A professional hardwood floor refinishing job takes 4 to 5 days from start through the final finish coat. That includes two days of sanding, a stain day if color is being changed, and two days for finish coats. Smaller jobs move faster. Very large homes or floors with heavy damage may take an additional day.
How long do I need to stay off hardwood floors after refinishing?
Plan to stay off the floor for 24 to 48 hours after the final coat is applied. Socks are fine after 24 hours in most cases. Hard-soled shoes and pets should wait the full 48. Area rugs should not go back for at least two weeks, since trapping moisture under a rug before full cure can cloud the finish.
Can I sleep in my house during hardwood floor refinishing?
For the sanding phase, most homeowners stay in the home as long as the refinished rooms are sealed off and you have a clean path to a bedroom and bathroom. On finish coat days, the odor from water-based finishes is mild enough that most people stay home with windows open. Oil-modified polyurethane is significantly stronger and often requires leaving for 24 to 48 hours. We use water-based finishes exclusively, so staying home on coat days is usually fine.
Does staining add time to the refinishing process?
Yes, by roughly one day. After sanding is complete, stain is applied and needs to dry fully before the first finish coat goes down. That typically means an overnight wait, which shifts the finish coat schedule by a day. Floors receiving a clear finish with no stain skip that step entirely.
How long before I can put furniture back after refinishing?
Light furniture like chairs can go back after 5 to 7 days. Heavy pieces like sofas, beds, and dining tables should wait the full cure period for the finish you chose: 3 days for Bona Traffic HD, 5 days for Bona Mega One or Rubio Monocoat. Moving furniture back too early risks denting or scratching a finish that looks dry but has not yet reached full hardness.
What is the difference between dry time and cure time for hardwood floor finish?
Dry time is how long before you can walk on the floor without leaving marks. Cure time is how long until the finish reaches its full hardness and chemical resistance. A finish can be dry in 24 hours but still be soft enough to dent under furniture legs for another week. Respecting cure time protects the finish from permanent damage before it has fully hardened.
